Liquidated Damages

Back to Clauses Guide

TL;DR:Liquidated damages work when they're grounded in reality. Document the loss estimate, tie the rate to something measurable, cap the exposure, and decide upfront whether LDs are the exclusive remedy or a floor. The clause should feel like a fair allocation of risk, not a weapon. If a reasonable person would look at the LD rate and think "that's a punishment, not an estimate," a court probably will too.

What is a Liquidated Damages clause?

Liquidated damages (LDs) are a contractual mechanism for pre-agreeing the financial consequences of a specific breach. Instead of going to court to prove what a delay or failure actually cost, the parties fix the amount (or formula) at the time of contracting. The clause saves time, reduces litigation risk, and gives both sides certainty - provided the amount represents a genuine pre-estimate of the loss the innocent party would suffer.

The provision is standard in construction, EPC, supply, and technology contracts where time-is-of-the-essence obligations are common and actual damages are difficult to calculate after the fact. But it became a flashpoint during the COVID-19 supply chain disruptions of 2020-2022, when performing parties across industries triggered LD provisions at scale and receiving parties discovered their LD rates either didn't reflect real-world losses or were so high that courts refused to enforce them. The lesson: an LD clause that isn't grounded in a genuine loss estimate is either toothless or unenforceable.

Typically found in the Remedies, Delay, or Performance section of commercial contracts, the clause:

• Fixes a specific dollar amount or formula for a defined breach.
• Must represent a genuine pre-estimate of loss (not a penalty).
• Usually includes a cap on total LD exposure.
• May specify whether LDs are the sole remedy or in addition to general damages.
• Often ties to milestones, completion dates, or SLA targets.

Liquidated Damages vs. Penalties:

  • Liquidated damages are enforceable because they represent a genuine attempt to pre-estimate the loss that would flow from a specific breach. The key test: at the time the contract was signed, was the amount a reasonable approximation of anticipated loss? If yes, it's an LD. If it's designed to punish the breaching party or compel performance through fear of an outsized payout, it's a penalty - and penalties are unenforceable in most common law jurisdictions.
  • The penalty doctrine has evolved differently across jurisdictions. In the U.K., the Supreme Court in Cavendish Square Holding v. Makdessi (2015) replaced the old "genuine pre-estimate" test with a broader proportionality analysis: a clause is penal if it imposes a detriment that is "out of all proportion to any legitimate interest" the innocent party has in enforcement. In the U.S., courts still largely follow the Restatement (Second) of Contracts approach - the amount must be reasonable in light of anticipated or actual loss, and damages must have been difficult to estimate at the time of contracting.

A well-drafted Liquidated Damages clause contains:

  1. Defined Trigger: What specific breach activates the LD - late delivery, missed milestone, SLA failure, quality defect. The trigger must be objective and measurable. Vague triggers like "material breach" invite disputes about whether the LD applies at all.
  2. Rate or Formula: The daily, weekly, or per-incident rate. For delay LDs in construction, a typical range is 0.05%-0.5% of contract value per day of delay. For SaaS SLA credits, 5%-25% of monthly fees per qualifying outage. The rate should be supportable by a documented loss calculation.
  3. Cap on Total Exposure: Almost every LD clause includes a ceiling - typically 5%-20% of total contract value. Without a cap, the performing party's exposure is theoretically unlimited, which courts may view as evidence of a penalty. The cap is one of the most heavily negotiated numbers in any LD clause.
  4. Exclusive Remedy Language: Whether LDs are the sole and exclusive remedy for the covered breach, or whether the innocent party can also claim general damages. The performing party wants exclusivity (so total exposure is capped and predictable). The receiving party wants to preserve the right to claim actual damages if they exceed the LD amount.
  5. Genuine Pre-Estimate Statement: A recital confirming that the parties have agreed the LD amount represents a genuine pre-estimate of the loss that would be suffered. This language doesn't guarantee enforceability, but courts treat it as evidence that the parties turned their minds to the question.
  6. Cure Period: Whether the performing party gets a grace period to fix the breach before LDs start accruing. Construction contracts commonly allow 7-14 days. SaaS agreements may not allow any cure period for uptime SLAs because the damage from downtime is immediate.
  7. Carve-Outs: Events that suspend or excuse LDs - force majeure, acts or omissions of the other party, change orders, or delays caused by third parties outside the performing party's control.

Market Position & Benchmarks

Where Does Your Clause Fall?

  • Employer-Favourable: LD rate at 0.3%-0.5% of contract value per day; cap at 15%-20%; LDs are a floor (not exclusive remedy), preserving the right to claim general damages above the LD amount; no cure period; limited force majeure carve-outs.
  • Balanced / Market-Standard: LD rate at 0.1%-0.2% of contract value per day; cap at 10%; LDs are the exclusive remedy for the covered breach; 7-day cure period; standard force majeure and change-order carve-outs; genuine pre-estimate recital included.
  • Contractor-Favourable: LD rate at or below 0.05% per day; cap at 5% of contract value; LDs are the sole and exclusive remedy for all delay-related claims; 14-day cure period; broad carve-outs including weather, supply chain disruption, and any owner-caused delay; early-completion bonus at matching rate.

Market Data

  • In international EPC contracts, delay LD caps between 8% and 12% of contract value are the most commonly negotiated range, with 10% serving as the default starting point in FIDIC-based contracts.
  • SaaS service-credit regimes typically cap monthly credits at 25%-30% of the affected month's fees; credits exceeding 50% are rare and usually signal a heavily customer-favourable deal.
  • Construction industry surveys (including ARCADIS and Navigant data) show that approximately 60% of delay LD disputes arise from ambiguous trigger definitions rather than disagreements over the rate itself.
  • Post-COVID renegotiations saw a measurable shift toward broader force majeure carve-outs in LD clauses; an estimated 40% of renewed supply and logistics contracts added pandemic, epidemic, or supply-chain-disruption language to the LD suspension triggers between 2021 and 2023.
  • Courts in the U.S. have struck down LD rates exceeding 1% of contract value per day in multiple reported decisions, treating rates at that level as presumptively penal absent compelling evidence of proportional loss.
  • The inclusion of an early-completion bonus alongside delay LDs correlates with higher enforceability rates in contested proceedings; adjudicators and arbitrators view the symmetry as evidence of genuine risk allocation rather than punishment.

Sample Language by Position

Employer-Favourable: "The Contractor shall pay to the Employer liquidated damages at the rate of [0.4]% of the Contract Price for each day of delay beyond the Date for Completion, up to a maximum of [20]% of the Contract Price. The Parties agree that this amount represents a genuine pre-estimate of the Employer's loss. Payment of liquidated damages shall not relieve the Contractor of liability for any other loss, cost, or damage suffered by the Employer as a result of such delay."
Balanced: "If the Contractor fails to achieve Substantial Completion by the Guaranteed Completion Date, the Contractor shall pay to the Employer, as liquidated damages and not as a penalty, the sum of [0.15]% of the Contract Price per day of delay, subject to a maximum aggregate liability for delay liquidated damages of [10]% of the Contract Price. Liquidated damages shall be the Employer's sole and exclusive remedy for delay. No liquidated damages shall accrue during any period of Excusable Delay as defined in Clause [X]."
Contractor-Favourable: "In the event of delay beyond the Completion Date not attributable to an Excusable Delay Event, the Contractor shall pay liquidated damages at the rate of [0.05]% of the Contract Price per calendar day, subject to a cap of [5]% of the Contract Price. Liquidated damages shall constitute the Employer's sole and exclusive remedy for any and all claims arising from or related to delay. If the Contractor achieves Substantial Completion prior to the Completion Date, the Employer shall pay an early-completion bonus at the same daily rate, subject to the same cap."

Examples:

  • Construction / EPC Contract: The contractor pays delay LDs of $25,000 per day for each day beyond the guaranteed completion date, subject to a cap of 10% of the contract price. The owner's only remedy for delay is the LD payment - it cannot claim additional delay damages. But if the delay is caused by an owner-directed change order or a force majeure event, the completion date is extended and no LDs accrue during the extension period.
"If the Contractor fails to achieve Substantial Completion by the Guaranteed Completion Date, the Contractor shall pay to the Owner, as liquidated damages and not as a penalty, the sum of [amount] per day for each day of delay, subject to a maximum aggregate liability for delay liquidated damages of [cap]% of the Contract Price. The Parties acknowledge that this amount represents a genuine pre-estimate of the loss the Owner would suffer from late completion."

  • SaaS Agreement: If monthly uptime falls below 99.9%, the customer receives service credits equal to 10% of that month's fees for each 0.1% below the SLA target, capped at 30% of the monthly fee. Credits are applied against the next invoice and are the customer's sole remedy for downtime. Credits do not apply to scheduled maintenance windows or outages caused by the customer's own systems.
"If the Service fails to meet the Availability SLA in any calendar month, Customer shall receive a service credit calculated as follows: for each 0.1% that actual availability falls below the SLA target, a credit of [X]% of that month's fees, subject to a maximum credit of [cap]% of the monthly fee. Service credits are Customer's sole and exclusive remedy for failure to meet the Availability SLA and shall be applied against the next monthly invoice."

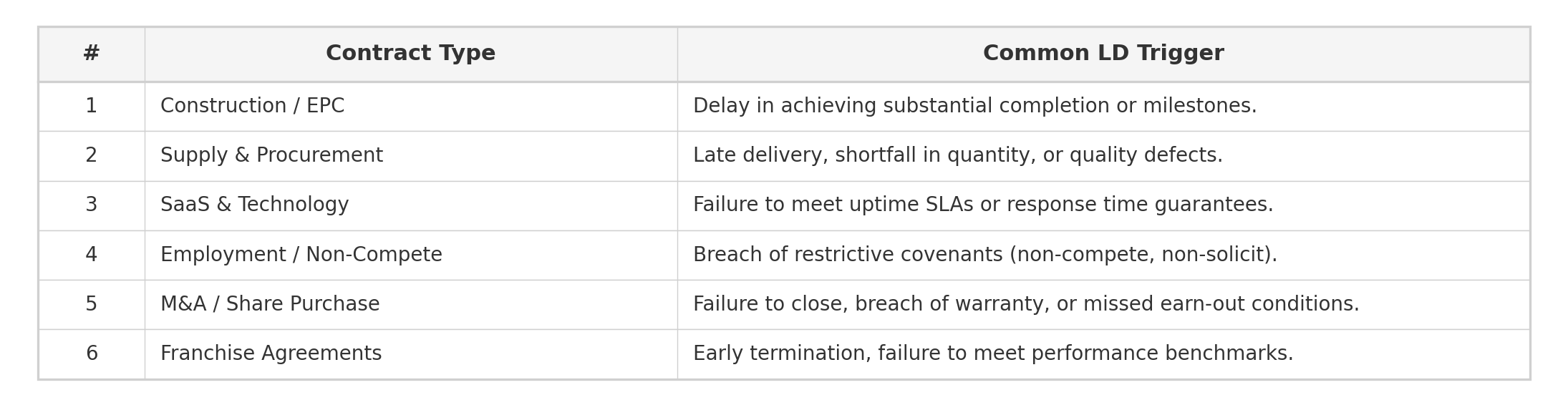

Contract types where liquidated damages are common:

Contract types where liquidated damages are common

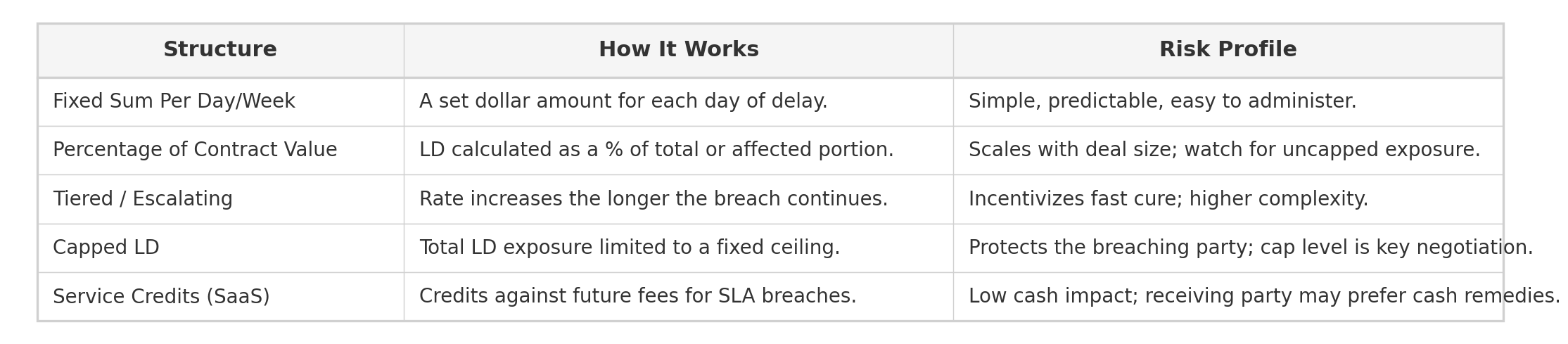

Common LD structures:

Common liquidated damages structures

Negotiation Playbook

Key Drafting Notes

  • Tie the Rate to a Documented Methodology: The LD rate should be traceable to a calculation memo prepared at or before the time of contracting. Include estimated daily overhead, lost revenue, third-party costs, or whatever loss the LD is meant to approximate. A contemporaneous record is the strongest evidence against a penalty challenge, and its absence is the most common reason LD clauses fail in court.
  • Coordinate LDs with the Limitation of Liability Cap: Confirm whether LD payments count toward the contract's aggregate liability cap or sit outside it. If the aggregate cap is $2 million and the LD cap is $1 million, state explicitly whether the LD amount erodes the aggregate cap. Ambiguity on this point generates litigation and can leave the receiving party with less protection than it expected.
  • Use a Sliding Scale for Multi-Milestone Contracts: Where the contract has phased deliverables, consider milestone-specific LD rates rather than a single blanket rate. A delay on a critical-path milestone may cause far greater loss than a delay on a non-critical deliverable. Sliding-scale rates demonstrate that the parties turned their minds to proportionality, which strengthens enforceability.
  • Pair Delay LDs with an Early-Completion Bonus: Courts and tribunals view symmetry as evidence of reasonableness. If the contractor pays $25,000/day for late completion, offering $25,000/day (or a fraction) for early completion signals that the LD rate is calibrated to actual economic impact, not punishment. This is now standard practice in large infrastructure and EPC contracts.
  • Specify Whether LDs Are a Floor or a Ceiling: "Sole and exclusive remedy" language caps the receiving party's recovery at the LD amount. If LDs are intended as a minimum (with the right to claim additional actual damages above the LD), draft that explicitly. The default interpretation in most jurisdictions treats LDs as a ceiling unless the contract says otherwise.

Common Pitfalls

  • Round-Number Rates Without Justification: A daily LD of exactly $50,000 looks arbitrary. Courts are more comfortable with $47,500/day when it matches a documented daily overhead figure. Clean round numbers invite scrutiny; calculated figures invite deference.
  • No Cap on Total LD Exposure: Uncapped LDs create theoretically unlimited liability, which courts may treat as evidence of a penalty. Even where the receiving party resists a cap, some ceiling is better than none; otherwise the entire clause is at risk of being struck down.
  • Vague or Subjective Triggers: Tying LDs to "material breach" or "unsatisfactory performance" invites threshold disputes before the LD rate even becomes relevant. Use objective, measurable triggers: a specific date, a defined SLA metric, or a quantified defect rate.
  • Ignoring Interaction with General Damages: If the LD clause is silent on exclusivity, the receiving party may argue it can collect both LDs and general damages for the same breach. The performing party may argue the opposite. Either outcome is defensible, which means the clause has failed to provide the certainty that was its entire purpose.
  • Failing to Address Concurrent Delay: In construction and infrastructure projects, delay is rarely caused by one party alone. If the clause does not address how LDs apply when both parties contribute to delay (concurrent delay), the performing party will argue that no LDs should accrue, and the dispute will turn on expert evidence rather than the contract's plain terms.

Key drafting notes for a Liquidated Damages clause:

  • Document the Estimate: The single best defence against a penalty challenge is a contemporaneous record showing how the LD amount was calculated. Keep a memo or schedule showing the estimated daily cost of delay, lost revenue, extended overhead, or whatever loss the LD is meant to approximate. If litigation comes, this memo is your best evidence.
  • Avoid Round Numbers Without Justification: A daily LD of exactly $50,000 looks arbitrary unless you can show it was derived from a calculation. Courts are more likely to uphold $47,500/day if it matches a documented daily overhead figure than a clean round number that looks like it was picked from thin air.
  • Exclusive Remedy vs. Minimum Floor: If LDs are the exclusive remedy, the receiving party cannot claim more even if actual damages exceed the LD. Some contracts structure LDs as a minimum floor instead - the receiving party gets the LD amount or actual damages, whichever is greater. This is much harder for the performing party to accept but may be appropriate where the receiving party's actual loss is unpredictable and potentially large.
  • Interaction with Limitation of Liability: Make sure the LD clause and the limitation of liability clause work together. If the contract has an aggregate liability cap of $1 million and the LD cap is $500,000, clarify whether LDs count toward the aggregate cap or sit outside it. Ambiguity here generates litigation.
  • Bonus for Early Completion: In construction and infrastructure contracts, pairing LDs with an early completion bonus creates a balanced incentive structure. If the contractor finishes late, it pays LDs; if it finishes early, it earns a bonus. Courts view this symmetry as evidence that the LD rate is reasonable rather than punitive.

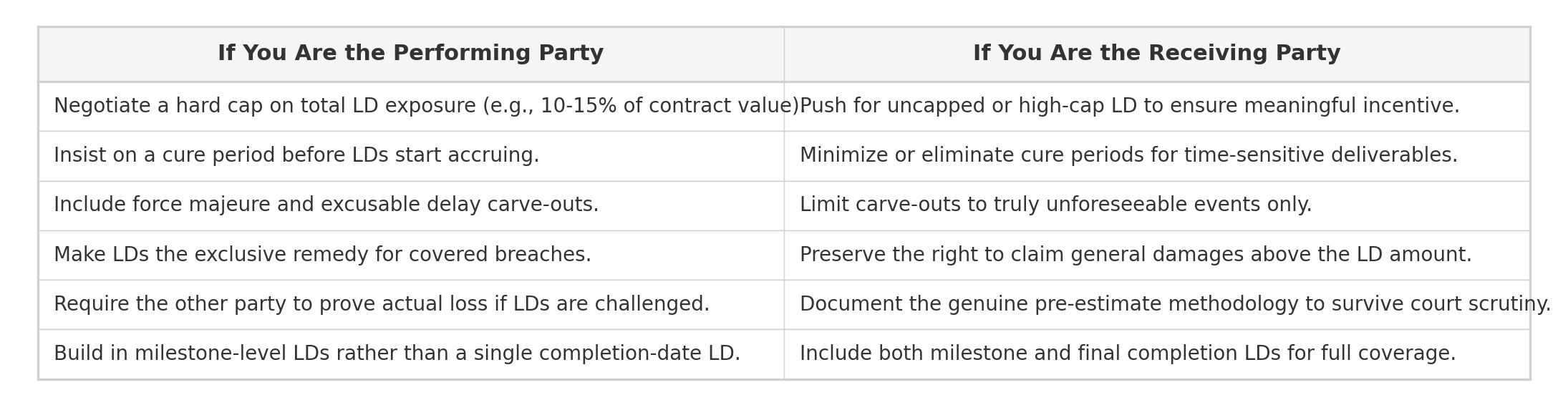

Liquidated damages drafting checklist

Historic note:

The distinction between liquidated damages and penalties traces back to English equity courts in the 17th and 18th centuries, which routinely refused to enforce penal bonds - instruments requiring payment of a grossly disproportionate sum upon default. The leading early case is Dunlop Pneumatic Tyre Co v. New Garage & Motor Co (1915), where the House of Lords set out the classic tests for distinguishing an LD from a penalty. That framework held for a century until the U.K. Supreme Court modernized it in Cavendish Square Holding v. Makdessi (2015), shifting from a mechanical "genuine pre-estimate" test to a broader proportionality inquiry. In the U.S., the Uniform Commercial Code (Section 2-718) and the Restatement (Second) of Contracts (Section 356) both provide that LDs are enforceable only if reasonable in light of anticipated or actual harm and if actual damages would be difficult to prove.

Jurisdiction specific notes:

  • U.S.: Courts apply a two-part test: (1) actual damages must have been difficult to estimate at the time of contracting, and (2) the LD amount must be a reasonable forecast of the likely harm. Some states (California, New York) are stricter than others. California Civil Code Section 1671 creates a presumption that LDs in non-consumer contracts are valid, but courts can still strike them down. In construction disputes, delay LDs between 0.05% and 0.5% of contract value per day are generally upheld; anything above that range attracts closer scrutiny.
  • U.K.: Following Cavendish/Makdessi and the companion case ParkingEye v. Beavis (2015), a clause is penal only if it imposes a detriment "out of all proportion to any legitimate interest of the innocent party in the enforcement of the primary obligation." This is a higher bar for challenging LDs than the old test, and it makes well-drafted LD clauses harder to overturn. But the doctrine still applies - and courts will still strike down clauses that are designed to punish rather than compensate. The key to surviving challenge: demonstrate a legitimate commercial interest in the LD amount, not just lost revenue.

Drafting tip:

Always include a schedule or annex showing the methodology behind the LD calculation. Attach it to the contract or reference it in the recitals. Even if the methodology isn't perfect, the fact that the parties engaged with the question of loss at the time of contracting is strong evidence of a genuine pre-estimate. Courts punish laziness - not imprecision.
